Madison Reservoir Dam (Lake Moraine) Rehabilitation Project
The New York State Canal Corporation is the owner of the Madison Reservoir Dam in the Town of Madison (Madison County) and is responsible for ensuring its safe operation. It was constructed in 1836 as an impoundment of Madison (Payne) Brook as a feeder to the Chenango Canal. While the reservoir and dam are no longer used as part of the New York State Canal System, the Canal Corporation continues to manage water levels through the dam. Water levels are managed to support seasonal recreational use, but also to allow for dam inspections and maintenance when necessary.
The Canal Corporation plans to rehabilitate the dam to enhance its safety and ensure it continues to operate as designed so those who work, live, and recreate on and around Lake Moraine can continue to do so for many years to come.
This page serves to provide information about the dam, its history, and details of the upcoming rehabilitation project.
Why Now
Although the dam has been routinely inspected and repaired as needed, it has not been significantly rehabilitated since 1983. The work planned in the coming years is extensive, including replacement of the spillway and low-level outlet system that are used to manage water levels, and rehabilitation and improvements to the dam’s earthen embankments. An extensive rehabilitation will ensure the dam is designed to current standards and continues to function safely.

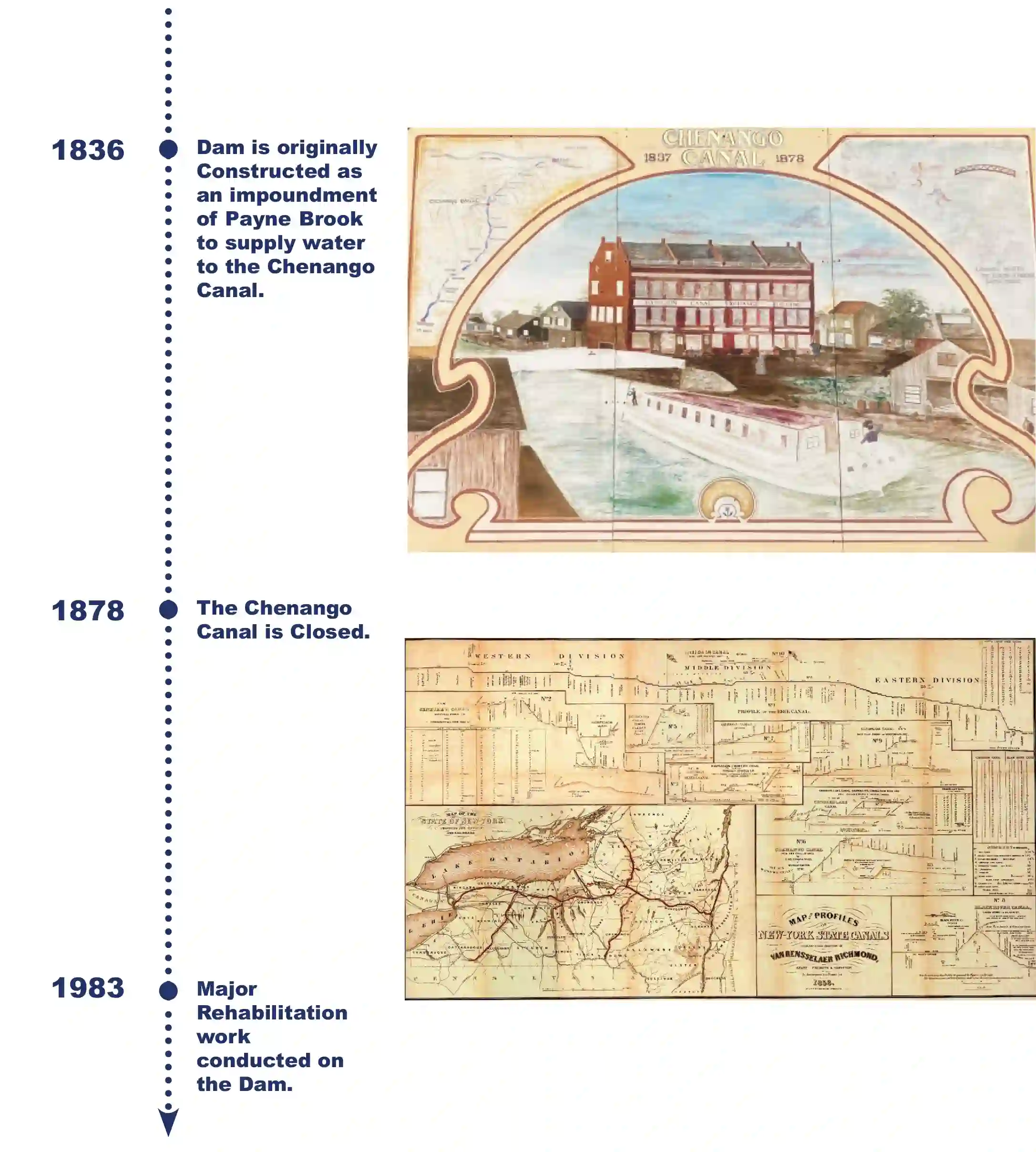

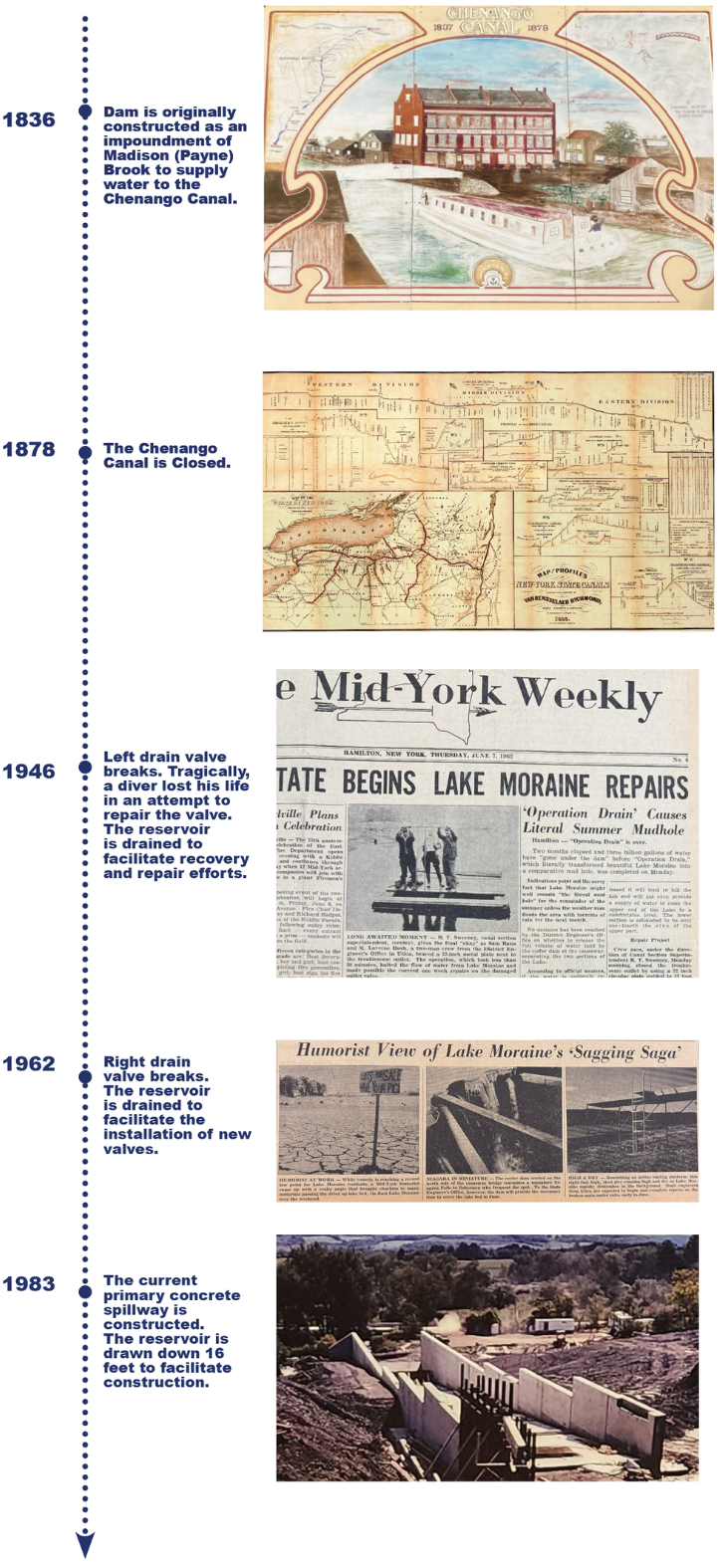

Dam History
Page Contents
For questions, comments, or concerns, contact:
Jackie Schillinger
Manager, Government and Community Relations
New York State Canal Corporation,
(c) 518 281-5510
Jacqueline.Schillinger@nypa.gov
Rehabilitation Project
This is a large-scale construction project that will take multiple years to complete. To complete
the project safely, efficiently and to manage flow through the reservoir, the work will be
completed in two main phases. During the first phase, the new low-level outlet system will be
constructed. During the second phase, the new spillway will be constructed. The reservoir will
remain drawn down throughout both of these phases of major work.

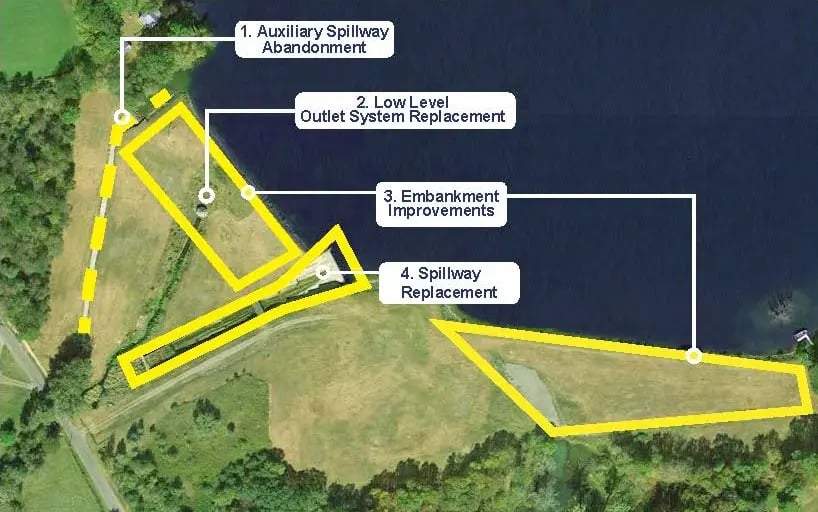

The primary components of the proposed rehabilitation project include:
- Demolishing the existing concrete spillway and replacing it with a larger
concrete labyrinth spillway. - Decommissioning the existing low-level outlet system and construction of a
new siphon low-level outlet system. - Improvements to the earthen embankments which include slightly raising
the dam crest in limited areas (less than 1-foot), buttressing and regrading the
embankment slopes, and installing drainage systems. - Various site enhancements like new access roads
Reservoir Drawdown
In order to complete the project safely, efficiently, and to manage flow through the reservoir,
the reservoir will be drawn down to a target level of 10 feet below the crest of the existing
spillway. The elevation of the existing spillway crest is 1211 BCD, and the target drawdown
elevation will be 1201 BCD. It is anticipated that the upper lake (north of the causeway) will be
maintained at a slightly higher level, around elevation 1205 BCD. This is subject to review and
permitting by New York State Department of Environmental Conservation (NYSDEC). (BCD is
an abbreviation for Barge Canal Datum which is the local datum that Canals uses at the site.)
At this time, the drawdown of the reservoir is anticipated to begin in Spring 2026, and the
reservoir is anticipated to reach the full drawdown level (elevation 1201 BCD) by Summer
2026. The reservoir is anticipated to remain drawn down for the full duration of major
construction work through the end of 2027.
The following images are renderings of what the reservoir may look like during the full 10-foot
drawdown – showing the approximate extents of water within the reservoir and areas that will
become exposed.
The following maps and files are provided to help those that may be affected to
plan and prepare for this period.
- The first link is a Drawdown Map which depicts the reservoir at the
full drawdown level along with the property lines of the surrounding area. - The second link is a Bathymetry Map which shows contours of the
reservoir along with the drawdown level.
Madison Reservoir Drawdown Map
Madison Reservoir Bathymetry Map
The following .kmz file can be downloaded and viewed interactively in Google Earth or other free online utilities. The file depicts different elevations (contours) within the reservoir, including the drawdown level and other relevant elevations.

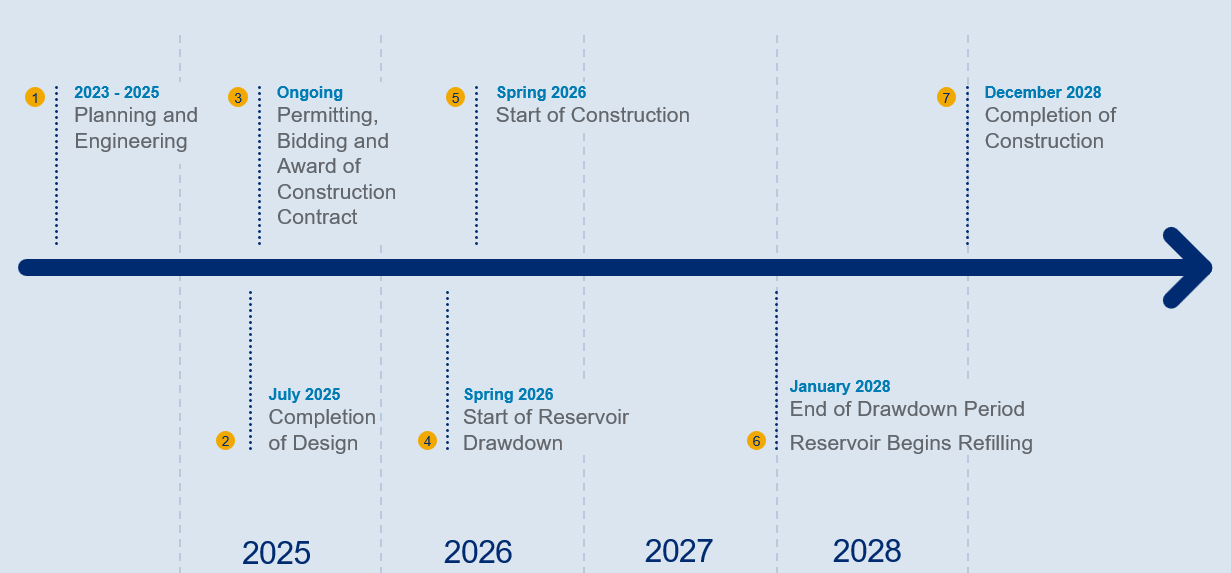

Project Schedule & Updates
We are proceeding as carefully and as thoughtfully as possible to ensure we carry
out a project that is done responsibly, safely, in accordance with all state and federal
regulations, while mitigating impacts to the community to the greatest extent possible.
![]()
Project Repository
The following project outreach and correspondence have been shared with the
community. Additional materials will be added here as they are shared.
- Public Information Sessions:
Public information Sessions were held on July 23, 2024, and October 8, 2025, at Colgate University. Recordings of each session and copies of the presentations can be viewed below.
October 2025 Public Information Session
October 2025 Public Information Session Presentation
July 2024 Public Information Session
July 2024 Public Information Session Presentation
- Reservoir Drawdown Notice:
In July 2025, a mailer was sent to notify properties surrounding the
reservoir of the anticipated reservoir drawdown.

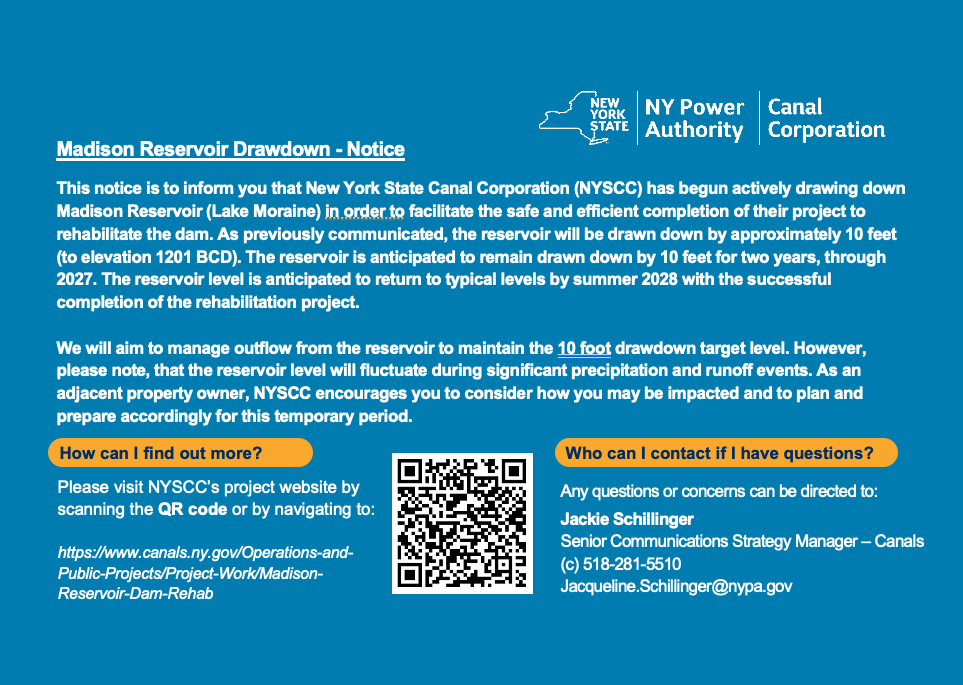

July 2025 Drawdown Notice Mailer
Frequently asked questions
When is the project slated to begin?
At this time, construction is anticipated to begin in 2026 with the majority of the work being completed in a two-year period, through 2027. Construction activities will extend through 2028. To facilitate construction and the safe execution of the work, it is anticipated that the reservoir will be drawn down by 10 feet for the duration of this two-year period from 2026 through 2027.
What will the project entail?
This project will be a comprehensive rehabilitation of the dam and entire site. The primary components of the project are replacement of the spillway and low-level outlet system, and rehabilitation and improvements to the earthen embankments. The improvements have been designed in consideration of current standards and will enhance the safety, operability, and longevity of the dam.
Are there current issues affecting the dam's safety?
The dam is classified by the NYSDEC as a high-hazard Class C dam. That means communities downstream from the dam would likely suffer severe damage or loss of life if the dam failed. While there is no imminent danger of failure, extensive repairs are needed to ensure long-term safety and integrity of the dam and its appurtenant structures.
What is the anticipated drawdown period?
The drawdown is slated to begin in March of 2026 to facilitate construction. It is anticipated that the reservoir will be drawn down for the two-year duration of major construction work from 2026 through 2027. At this time, we don’t anticipate that the reservoir will be drawn down more than 10 feet below the spillway crest elevation. Construction is anticipated to be completed in 2028.
What is the anticipated drawdown magnitude?
At this time, we anticipate that the reservoir will be drawn down to elevation 1201 BCD which is 10 feet below the spillway crest elevation.
How can I get updates about the project?
The Canal Corporation will post updates about the project’s progress on this website.
Where can I find more information about the reservoir?
You can find more information about the reservoir at https://dec.ny.gov/places/lake-moraine-madison-reservoir
